Audenreid

Updates on the progress of the construction of the Audenreid AMD Treatment System in the Catawissa Creek Watershed.

Tuesday, August 22, 2006

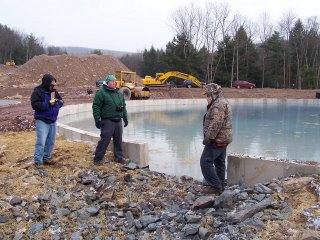

Damage from 2006 Flood


















Flow rates were estimated at nearly 300,000 gpm. The previous high flow was recorded at 30,000 gpm Posted by Picasa

Black discharge during 2006 Flood




 Posted by Picasa

Audenreid Dedication




 Posted by Picasa

Audenreid Dedication



 Posted by Picasa

Thursday, May 25, 2006


DIRECTIONS TO BRANDONVILLE FIRE COMPANY
& AUDENREID TREATMENT SYSTEM



FROM BLOOMSBURG:

Rte. 487 South to Mainville Road. Take Mainville Road towards MAINVILLE. Mainville Road Turns into PA-339. Continue on PA-339 to PA- 924 (approx. 15 miles). Turn Right onto PA-924.

BRANDONVILLE FIRE CO. (for the bus): Located at the intersection of PA-924 and PA-339, approximately ½ mile after your right turn onto PA-924. (Map A)



FROM HAZELTON:

BRANDONVILLE FIRE CO. (for the bus): Take PA-924 South (approx. 13 miles). Go straight through 924/ 339 intersection. Follow above directions. (Map A)


FROM FRACKVILLE:

BRANDONVILLE FIRE CO. (for the bus): Take 924 North to Brandonville (approx. 8 miles). Look for Fire Company on your right. Or, East Brandon Street will be on your left past the Fire Company. Follow above directions to treatment system. (Map A)


{Over for maps}


MAP A: Brandonville Fire Company; 10 Main Blvd., Ringtown, PA 17967-9687

Your Invited: Audenreid Dedication (June 17th, 2006)

On behalf of the Columbia and Schuylkill County Conservation Districts and the Catawissa Creek Restoration Association, it is my pleasure and honor to invite you to the Audenreid Tunnel Acid Mine Drainage [AMD] Treatment System dedication ceremony. This ceremony will be held on Saturday, June 17, 2006 at 1:30 p. m. The event will include an open house and tours beginning at 12:30 p. m. The press will be invited.

The Audenreid Tunnel Treatment System is the largest passive AMD treatment system ever built in Pennsylvania and perhaps anywhere, in terms of amount of water treated. This facility is capable of treating over 14,000 gallons per minute of AMD and, since beginning operation on December 15, 2005, has had a significant positive impact on the water quality of the Catawissa Creek. Fish are now being seen in about 25 miles of stream that have been biologically dead for over 75 years! Needless to say, we are very excited and wish to share our enthusiasm with our partners and the public.

The dedication ceremony will take place at the site of the treatment system rain or shine. Please be prepared for potentially wet weather and uneven terrain. There will be a bus that will transport public participants from the Brandonville Fire Co. in Brandonville starting at 12 p. m. (see Directions in next post).

We would appreciate your RSVP to Columbia County (570. 784.1310 ext. 102) or Schuylkill County Conservation District (570. 622. 3742 ext. 5) ASAP to assist in our planning. Please indicate number of people attending in your party.

This project is the culmination of efforts and support from many government agencies, businesses, and volunteer groups. It is our hope that you will be able to join us in celebrating the rebirth of the Catawissa Creek!

Tuesday, May 02, 2006

Aerial view of treatment system

Flushing Aluminum out of the cells

Wednesday, February 01, 2006

Water level drops, but still very high. (1 week after blowout)


 Posted by Picasa

Blowout location behind the intake system


 Posted by Picasa

High flows caused blowout at intake




Extremely high flows, resulting from large amounts of raina nd snow melt, casued a blowout behind the intake system. The intake system was not damaged, but the blowout will need to be repaired and remidied with a water pressure release component. Posted by Picasa

We are working on getting the siphons to turn off at the same time


 Posted by Picasa

This siphon chambers being filled


 Posted by Picasa

Work started on the siphons in early January


 Posted by Picasa

Thursday, December 15, 2005

Settling pond


Posted by Picasa

water leaving tank via overflow weir


Posted by Picasa

Settling pond outflow


Posted by Picasa

Monday, December 12, 2005

The fence is being installed today. The posts for tank 1 and 2 are installed.


 Posted by Picasa

Friday, December 09, 2005

The pH coming out of the overflow tested near 7.0 (up from 4.0).




The System was shut down to upgrade the overflow channels and to repair some minor leaks in the clean out pipes. The third tank will be tested early next week. Posted by Picasa

The tank overflows were being tested. The siphons will not be tested until later next week.


 Posted by Picasa

Tank 1 filled as planned (fill time per tank meets the expected 2 hour prediction)


 Posted by Picasa

The Agridrains functioned as expected and successfully controlled the water level of the tanks.


 Posted by Picasa

Another view of the distribution box handling the increased flow.


 Posted by Picasa
